E Squared Marine

E Squared Marine | 8,000 SF PEMB | Friendswood, TX

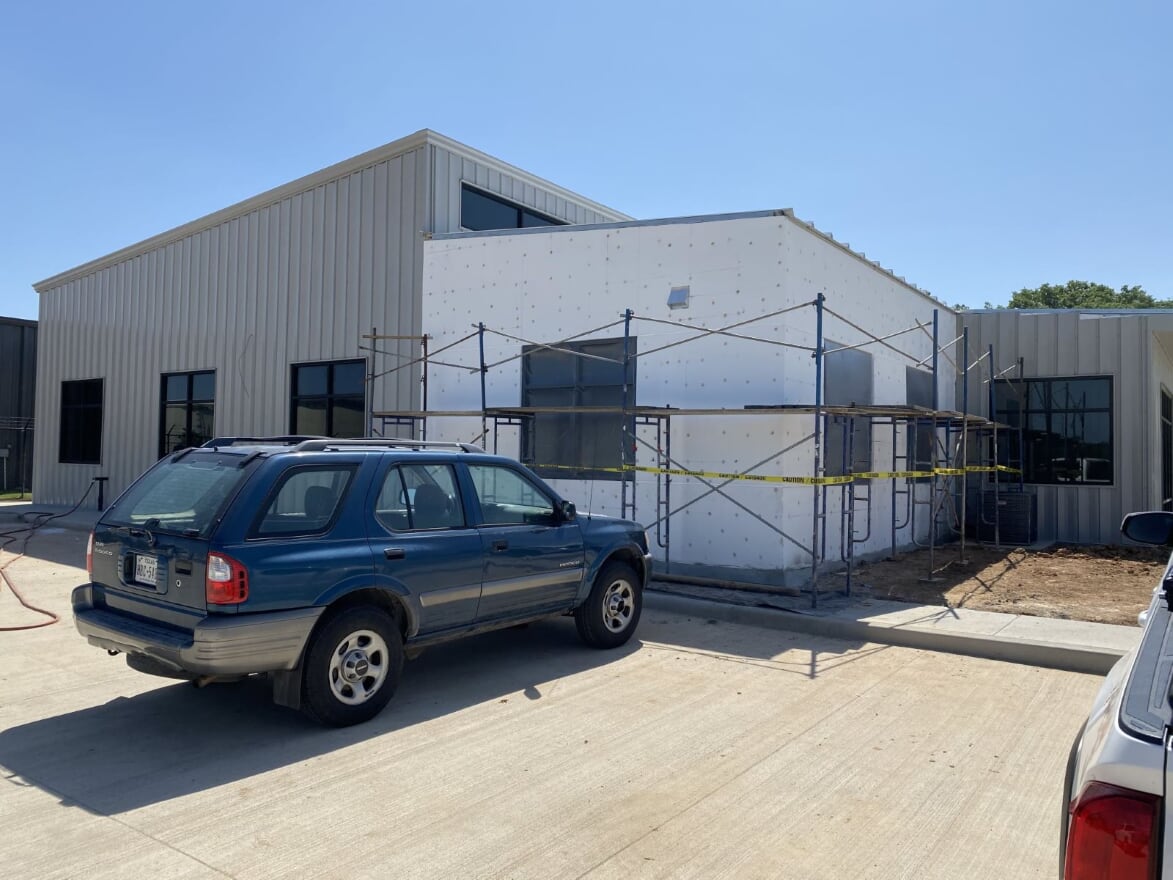

6.08.20 - Painting is near completion. This project will be completed next week, following landscaping,

17

1

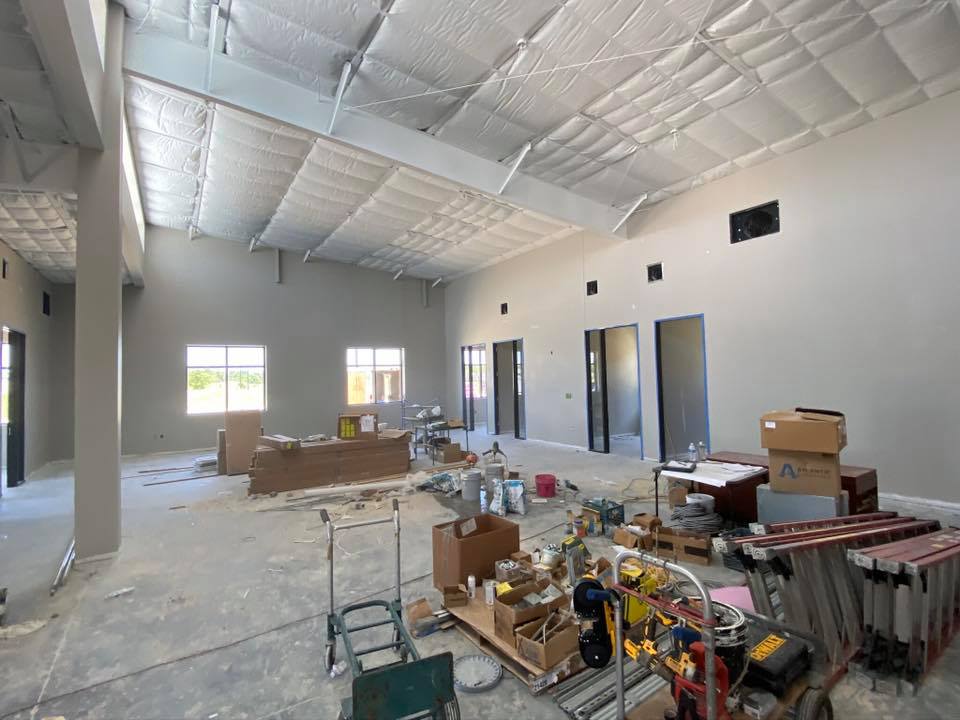

2

5

8

10

12

13

14

18

19

22

5.07.20 - Masonry contractors completed the stucco. The wall tile in the restrooms is being installed. M&M Erectors are trimming the building and installing the entry canopy,

95272295 3466569990024474 4243787503628189696 n

95295638 3466570110024462 8884433601769242624 n

95474192 3466570053357801 5326933484940296192 n

95675362 3466570183357788 2841176185482772480 n

95699204 3466570040024469 806365635784212480 n

95709329 3466570120024461 3469914760022065152 n

95775764 3466569980024475 1370859303530921984 n

95840461 3466570193357787 3700212267938217984 n

95857786 3466569786691161 2353273187761913856 n

95876930 3466569653357841 8050737933734379520 n

95903514 3466569880024485 836828296921481216 n

96243266 3466569666691173 2498851469332054016 n

96394352 3466569886691151 8287555408164290560 n

4.30.20 - Painters completed their work painting the walls and ceilings. Door frames are being installed. The masonry contractor began the stucco facade,

94767637 3447937445221062 774851119976284160 n

95135831 3447937215221085 7100166202596524032 n

95139936 3447937221887751 4156402837758148608 n

95148798 3447937285221078 6149323643705884672 n

95311911 3447937135221093 263539566944714752 n

95345094 3447937358554404 3414423859867156480 n

95698576 3447937291887744 6088845526311108608 n

95035828 3447937068554433 6895275157108031488 n

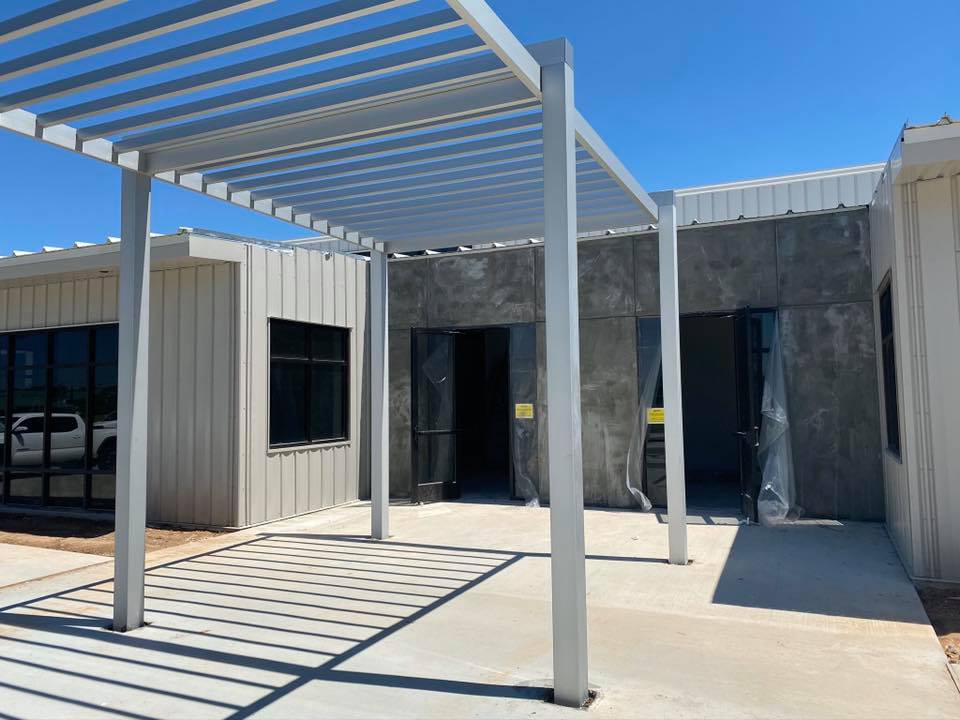

4.23.20 - The entry canopy is complete. Painters are spraying the exposured structure. Electricians are building the service panels,

13

1

2

3

4

5

6

7

8

9

10

11

12

4.14.20 - AVAdek is installing the entry pergola. HVAC ductwork is being installed. Electricians are roughing in the plugs and switches,

93386803 3407481645933309 2434384100413407232 n

93421089 3407481955933278 5939305695756156928 n

93423777 3407482055933268 2872725159813316608 n

93425236 3407482079266599 358783533340164096 n

93426695 3407481979266609 8432734476819234816 n

93429694 3407481669266640 3420630577236148224 n

93473676 3407481849266622 6554092477056286720 n

93482197 3407481739266633 1657674191605858304 n

4.02.20 - Interior buildout continues, window and door installation are also underway,

20200401 121708000 iOS

20200401 122405000 iOS

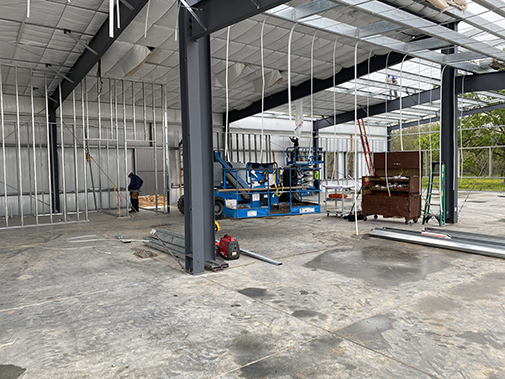

3.10.20 - Roof sheeting and siding are underway,

IMG 0051

IMG 0052

IMG 0053

IMG 0054

IMG 0055

IMG 0056

IMG 0057

3.02.20 - Crewmen have finished sheeting the east wall,

IMG 4491

IMG 4492

IMG 4493

IMG 4494

2.27.20 - Erectors continue to hang steel, and began sheeting the east wall,

IMG 9845

IMG 9849

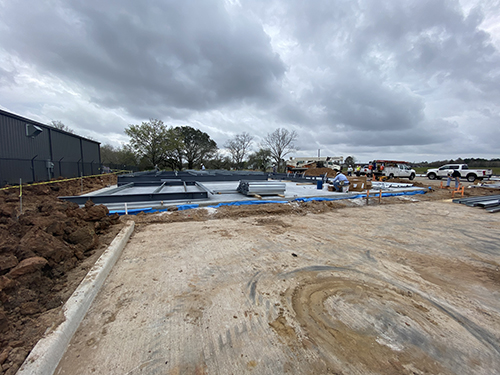

2.20.20 - The building is delivered and the erectors are shaking out and assembling the steel,

IMG 9654

IMG 9655

2.15.20 - Crews are pouring the foundation,

IMG 0350

IMG 0358

IMG 0360

2.11.20 - Crews are prepping for the foundation pour,

IMG 9636

IMG 9637

12.14.19 - Crewmen plan to pour paving on Monday,

E2 12.13

E2 12.13 7

E2 12.13 6

E2 12.13 2

12.12.19 - Site work continues,

E2 3

E2 5

E2

Crewmen will soon begin constructing a new 8,000 SF office building for E Squared Marine,

exterior thumb

Interior thumb

E Squared Marine | 8,000 SF PEMB | Friendswood, TX

3.10.20 - Roof sheeting and siding are underway,

IMG 0051

IMG 0052

IMG 0053

IMG 0054

IMG 0055

IMG 0056

IMG 0057

3.02.20 - Crewmen have finished sheeting the east wall,

IMG 4491

IMG 4492

IMG 4493

IMG 4494

2.27.20 - Erectors continue to hang steel, and began sheeting the east wall,

IMG 9845

IMG 9849

2.20.20 - The building is delivered and the erectors are shaking out and assembling the steel,

IMG 9654

IMG 9655

2.15.20 - Crews are pouring the foundation,

IMG 0350

IMG 0358

IMG 0360

2.11.20 - Crews are prepping for the foundation pour,

IMG 9636

IMG 9637

12.14.19 - Crewmen plan to pour paving on Monday,

E2 12.13

E2 12.13 7

E2 12.13 6

E2 12.13 2

12.12.19 - Site work continues,

E2 3

E2 5

E2

Crewmen will soon begin constructing a new 8,000 SF office building for E Squared Marine,
